Calem Blogs

Blogs of CalemEAM

Comparing Weekly vs Weeks of PM Schedules

There are two types of schedules when managing repeat tasks by weeks. Their differences are demonstrated by examples below.

  • A. "Weekly" schedule. It allows one to schedule a task to happen every week on one or more week days.
    • A next due date is calculated from the next day after the starting date, and find the next due day by moving one day at a time forward.
    • For instance, a PM has a weekly schedule every Monday (screenshot A below) and is floating. By floating, the next due time of a PM is calculated when a work order is completed.
      • A PM work order is generated from the PM with "Need by" of 4/25/22 in the work order on 4/18/22.
      • The PM work order is completed on 4/24/22.
      • The next due day is 4/25/22 - the first Monday from 4/24/22.
    • If the same PM is fixed (i.e., the release type of its PM Plan is fixed, not floating), the next due date is 5/2/22.
      • A PM work order is generated from the PM with "Need by" of 4/25/22 in the work order on 4/18/22.
      • The next due date of the PM is changed to 5/2/22 for fixed PMs.
      • The PM work order is completed on 4/24/22.
      • The next due day is 5/2/22 regardless when the PM is completed.
  • B. "Weeks" schedule (screenshot B). It allows one to schedule a task to happen every N weeks where N >= 1.
    • A next due date is calculated 7 or N*7 days from the starting date.
    • For instance, a PM has a "Weeks" schedule of every one week on Monday (screenshot B below) and is floating. By floating, the next due time of a PM is calculated when a work order is completed.
        • A PM work order is generated from the PM with "Need by" of 4/25/22 in the work order on 4/18/22.
        • The PM work order is completed on 4/24/22.
        • The next due day is 5/1/22 for floating PM. For PMs of fixed release, the next due date is 5/2/22 (Monday).
    • If the same PM is fixed (i.e., the release type of its PM Plan is fixed, not floating), the next due date is 5/2/22.
      • A PM work order is generated from the PM with "Need by" of 4/25/22 in the work order on 4/18/22.
      • The next due date of the PM is changed to 5/2/22 for fixed PMs.
      • The PM work order is completed on 4/24/22.
      • The next due day is 5/2/22 regardless when the PM is completed.

A. Weekly Schedule

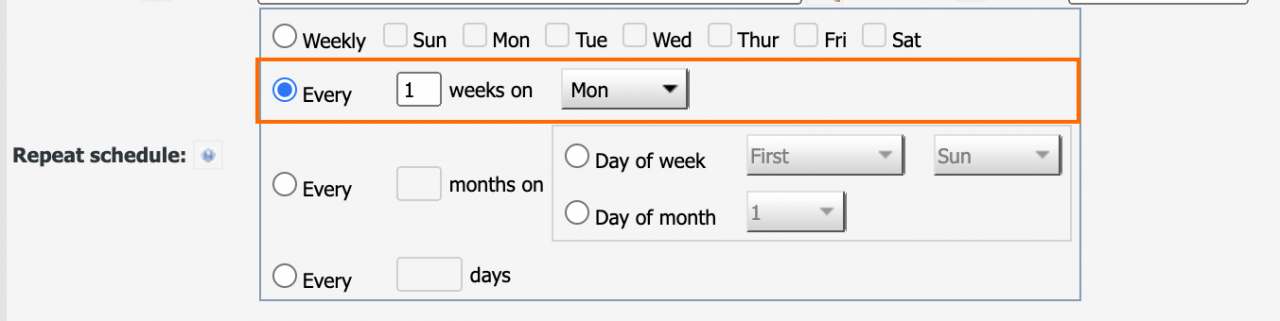

 B. Weeks Schedule
